Project Time Tracking for Flexible Effort Planning

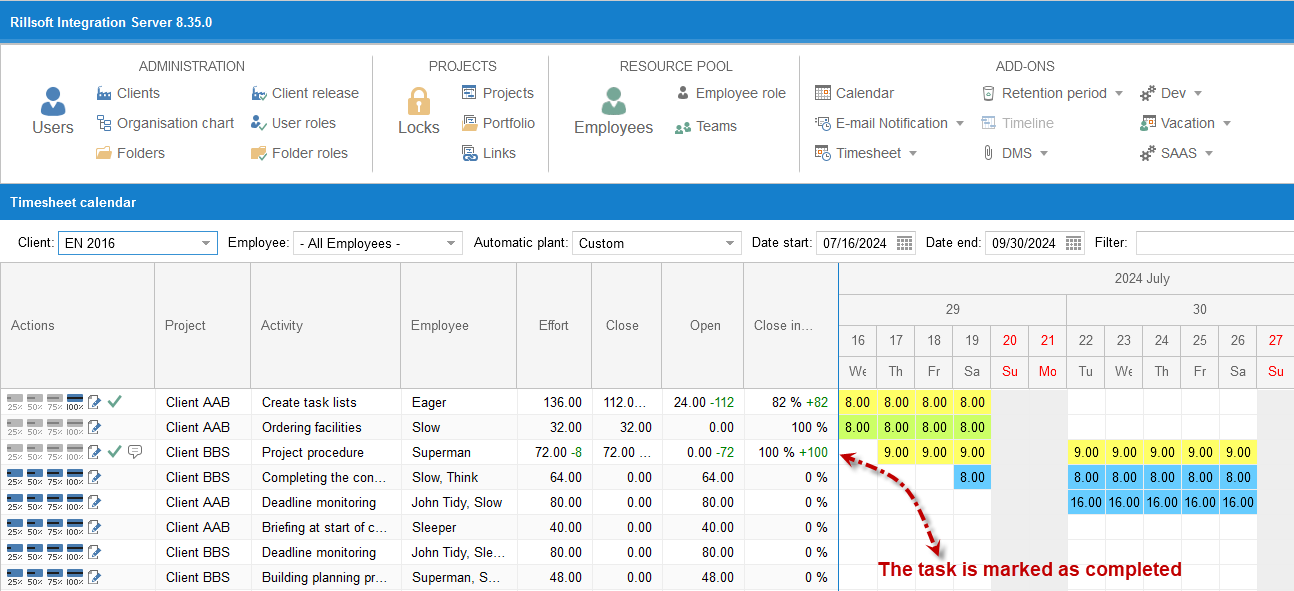

Dealing with deviations - managing remaining effort

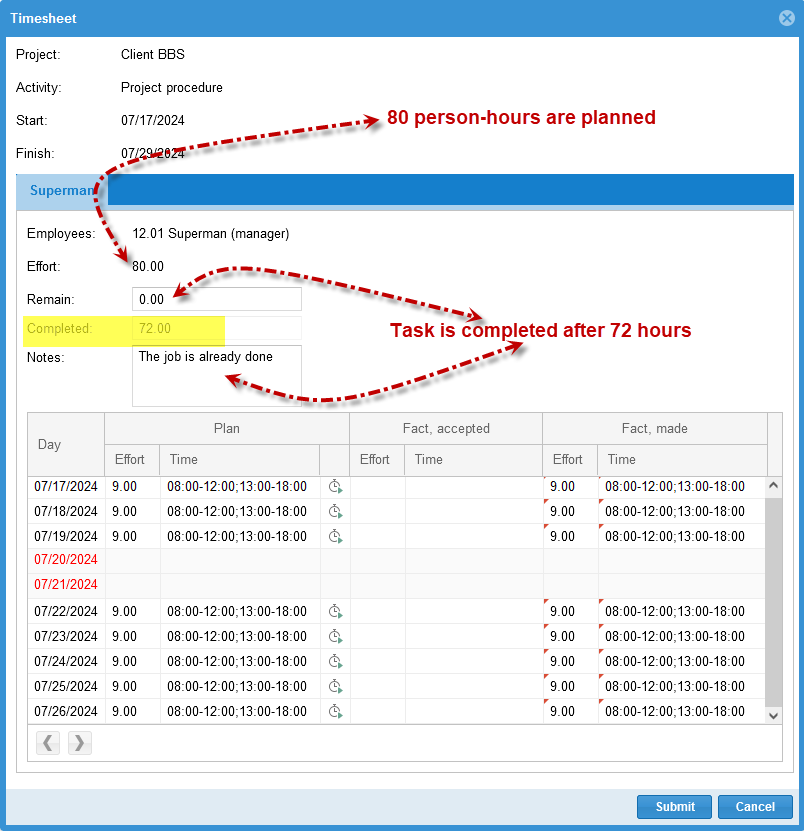

If there are discrepancies in your project, such as between planned and actual working hours or planned effort versus actual effort, you can enter these discrepancies in an input dialog during project time tracking.

Here, you can also find additional information about an effort plan for a task, such as notes or comments from colleagues.

managing-remaining-effort-note Flexibly adjust planned work effort during on-demand time tracking and manage remaining effort managing-remaining-effort Adjusting project effort after time tracking

Accepting feedback
